Skip to main content

Planning

Overview​

This page contains the scheduling for all approved work within the facility. It is designed for resource allocation and management, monitoring job progress, timelines, and departmental man-hours.

The page features four synchronized views that interact with each other, each serving a specific purpose: Filters, Table View, Gantt Chart, and Departments Hours.

Planning filters section
  • up: FILTERS
  • left: TABLE VIEW
  • right: GANTT CHART
  • down: DEPARTMENTS HOURS

You can expand or collapse these sections by moving the dividers between them.

Filters​

In addition to the standard filters, two unique options are available in this section:

Save icon
  • Filter Tasks by Date: When active, it displays only specific tasks within the selected date range. When inactive, it shows the entire job or joblist associated with those tasks.
Save icon
  • Zoom: This filter is dedicated exclusively to adjusting the time scale of the Gantt Chart.

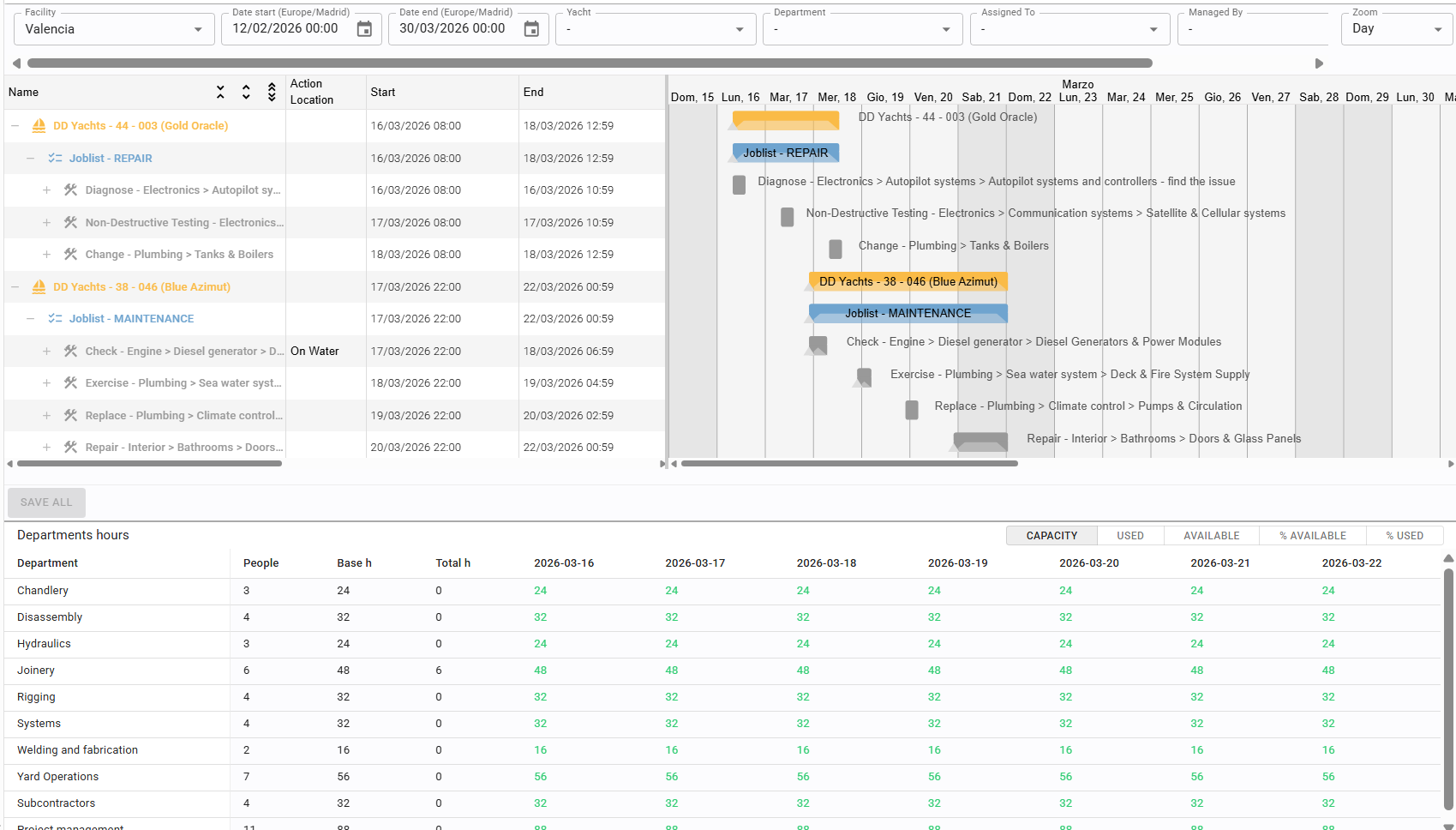

Table view​

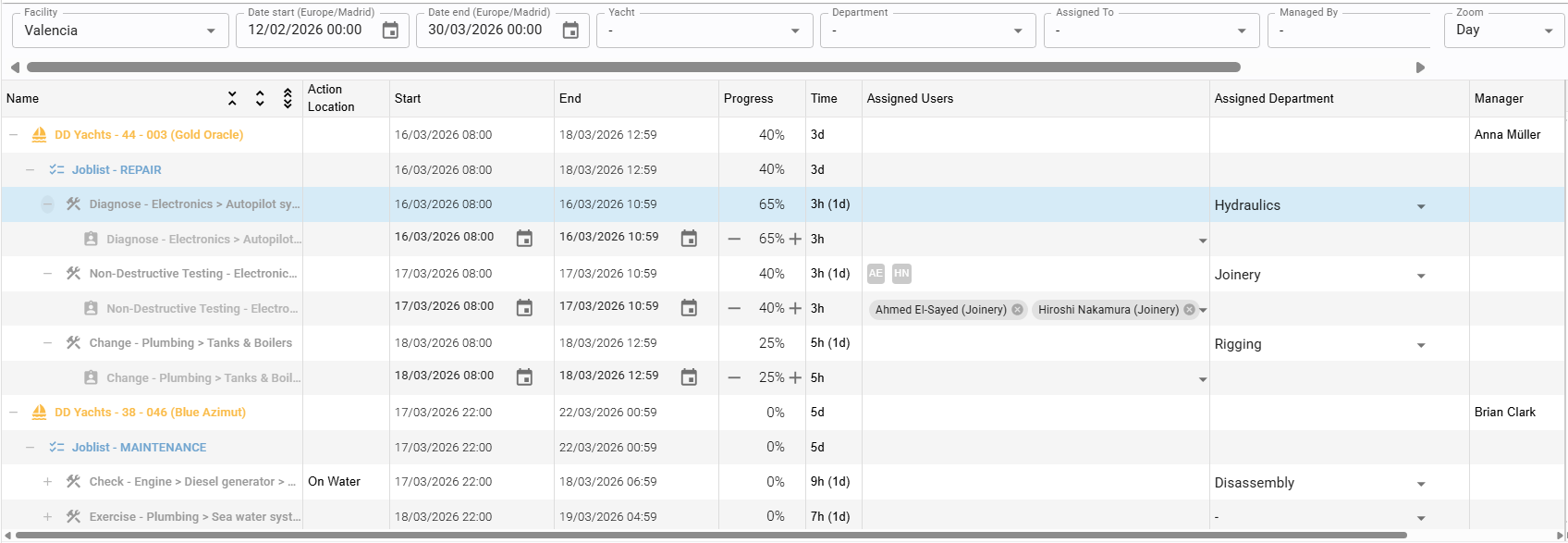

Planning table hierarchical view

The left side of the planning interface displays information in a hierarchical structure.

Elements can be expanded or collapsed using the + and - icons next to individual items or via the icons in the first column header..

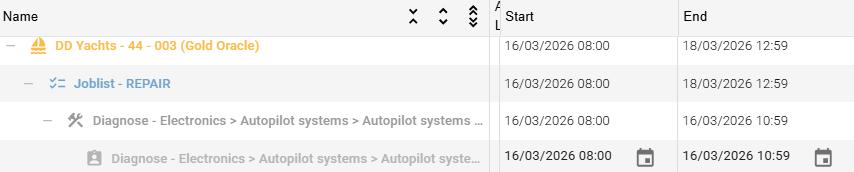

Start date and end date​

Dates must be set at the Task level; the dates for Jobs, Joblists, and Boats are automatically calculated based on their underlying tasks.

Task start and end dates

Update the progress status​

Progress percentage is updated at the Task level. The progress status for higher-level elements (Job/Joblist) is automatically aggregated.

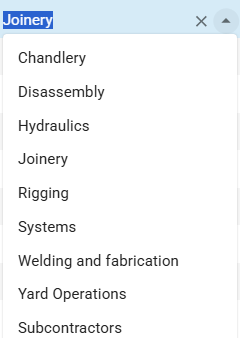

Assign job to department​

Save icon

A department can be assigned at the Job level.

Once assigned, the hours associated with that job are calculated toward that department's workload.

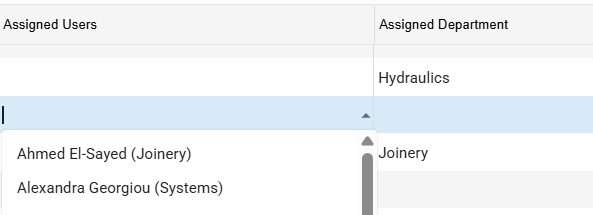

Assign task to user​

Save icon

A task can be assigned to one or more users, regardless of their primary department.

Note: If an assigned user belongs to a different department, the task hours will be deducted from their original department's availability.

Gantt chart​

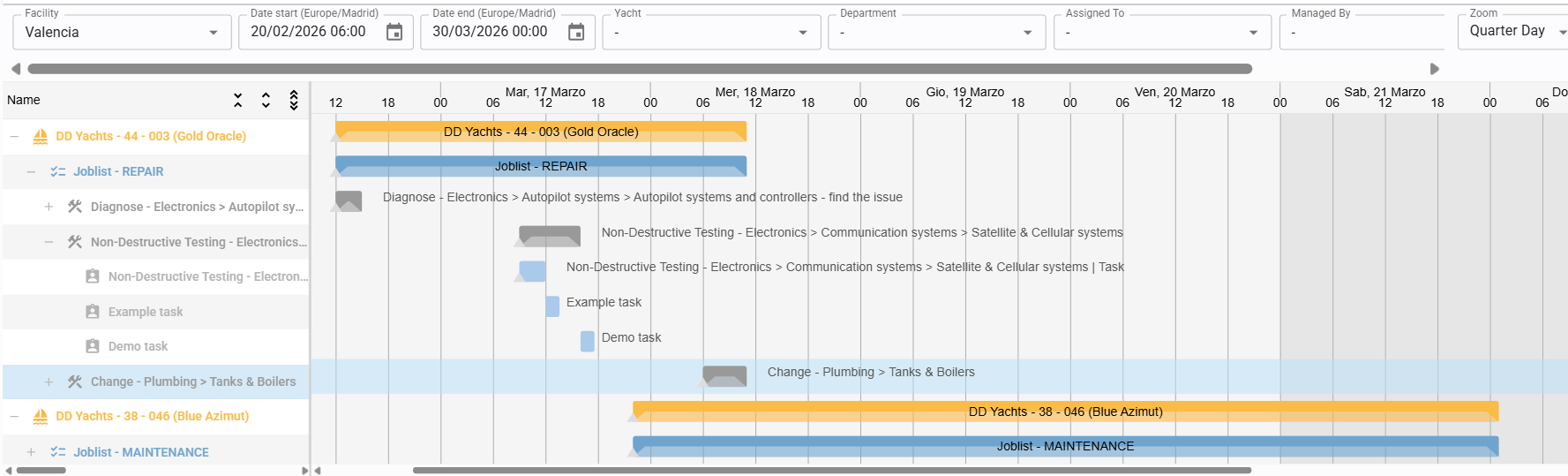

The right section of the screen provides a graphical representation (Gantt) of the table data

Planning Gantt chart view

Drag and drop elements​

Any element can be moved along the timeline using drag-and-drop. Related sub-elements will automatically shift to maintain the schedule's consistency.

Gantt drag and drop

Resize elements​

The duration of any element can be extended or shortened by clicking and dragging the edges of its respective bar (or using date-time inputs in the table section).

Add job to a joblist​

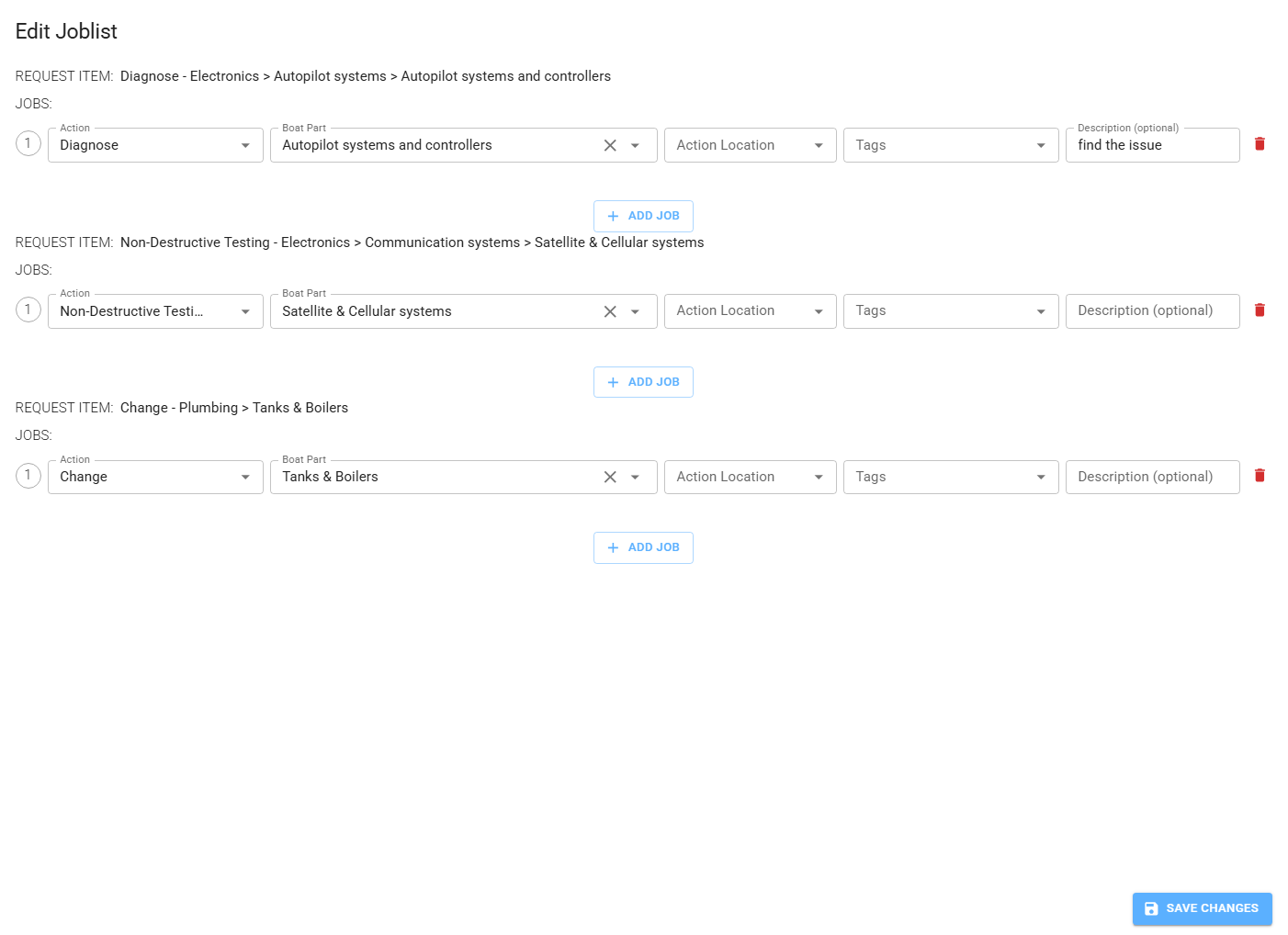

Right-clicking on a Joblist allows you to delete it or open the editor. In the editor, you can add new jobs using the "Add Job" button.

Add job to joblist from Gantt

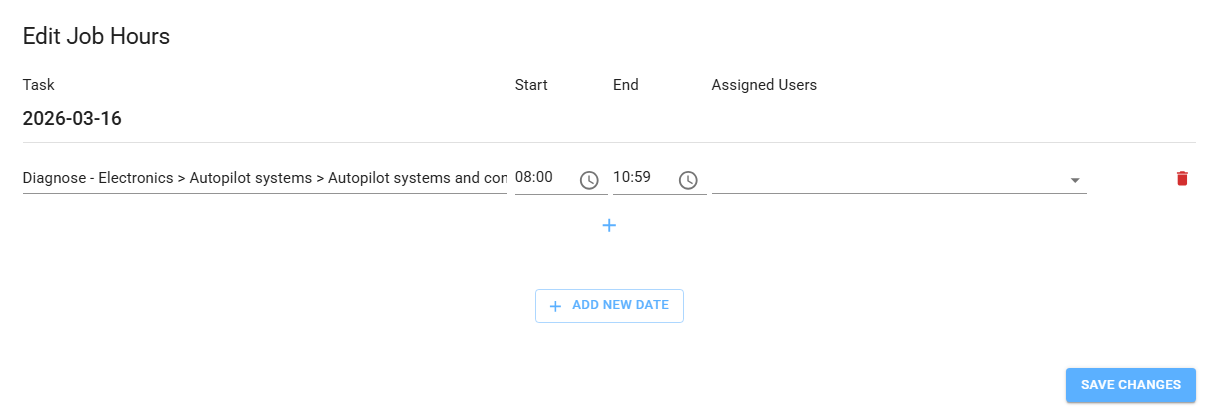

Add task to a job​

Right-clicking on a Job allows you to select "Edit Hours." Within this editor, you can add tasks on the same day using the + icon or add tasks for

different dates using the "Add New Date" button.

Edit hours add task

Move task​

Save icon

Right-clicking on a Task provides shortcuts to shift it directly to the previous or following day

Departments hours​

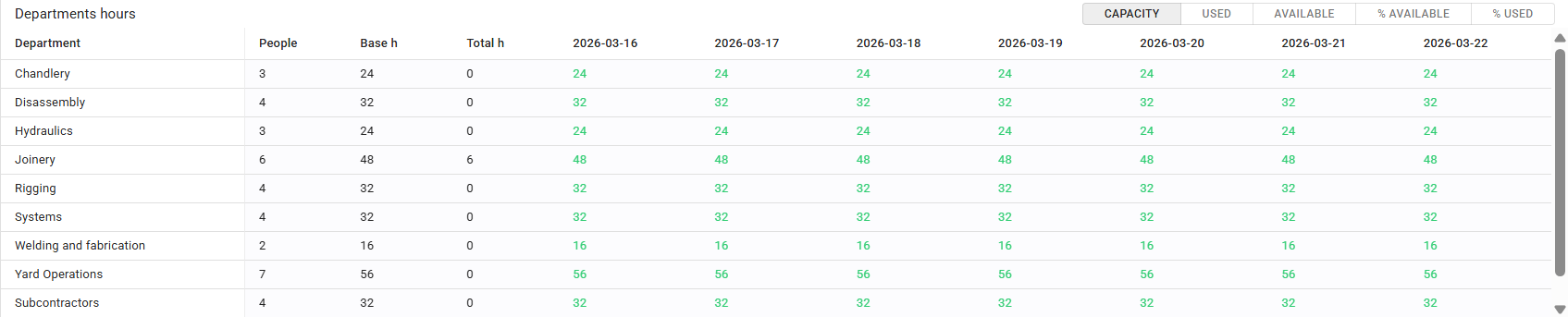

This section displays the capacity and total man-hours of each department on a day-by-day basis.

Departments hours overview

You can toggle between different data views: capacity, hours used, hours available, % available or % used

This view also tracks cross-departmental resource sharing, indicating where a department has provided staff to others or received additional resources.
